For SOHO, the 2 rooms created by putting partition board. Standard SOHO should only have 1 room.
Central Residence - Phase 2
Central Residence - Phase 2
|
|
Jan 7 2014, 05:27 PM
Return to original view | Post
#161
|
![]() ![]() ![]() ![]()
Senior Member
510 posts Joined: Jun 2012 |
For SOHO, the 2 rooms created by putting partition board. Standard SOHO should only have 1 room.
|
|
|
|
|
|
Jan 7 2014, 06:27 PM
Return to original view | Post
#162
|
![]() ![]() ![]() ![]()
Senior Member
510 posts Joined: Jun 2012 |
Single room or studio unit is still not so acceptable at the current time. At least 2 rooms can house a family with 1 or 2 children.
|
|
|
Jan 29 2014, 05:35 PM
Return to original view | Post
#163
|
![]() ![]() ![]() ![]()
Senior Member
510 posts Joined: Jun 2012 |
Update the progress. Now the maincon has moved up to 12th floor. The last update was 6thJan. It took 3 weeks to complete level 11
Expected to complete level 12 more than 2 weeks due to CNY holiday |
|
|
Feb 12 2014, 02:15 PM
Return to original view | Post
#164
|
![]() ![]() ![]() ![]()
Senior Member
510 posts Joined: Jun 2012 |

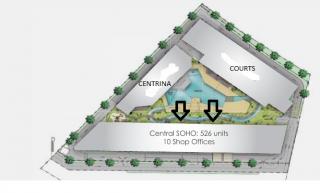

QUOTE(electroboy @ Feb 12 2014, 09:09 AM) in the picture i noticed that the right side of the ongoing construction soho building is "empty". is there where centrina/the court is supposed to be? (attached to soho) Dear Electroboy,The picture that u attached is the SOHO Building. The direction that we are seeing now is standing at the swimming pool and looking at the Type-S2 (731 sqft2). So on you right side is actually Centrina. Hope that I have clear your mind |
|
|
Feb 13 2014, 10:00 AM
Return to original view | Post
#165
|
![]() ![]() ![]() ![]()
Senior Member
510 posts Joined: Jun 2012 |
QUOTE(electroboy @ Feb 12 2014, 04:01 PM) yerp.. mine is S2, 731sqft facing swimming pool Yes, should have 13 units. thanks for clarifying, yeah. that's what i thought too, but this morning i spend sometimes to make a comparison with the layout that they have on the brochure with the progress pic.. that side (facing pool) should have 13 units/floor according to floorplan but i'm seeing lesser than that in the progress picture.. maybe i didn't count properly or i cant see everything from that pic. You can see thru the picture that the right side of the construction is incomplete. The level is only up level 6 (Carpark). I think they have some issue with that area. They are now picking up to catch up with the progress as per others units. |
|
|
Feb 13 2014, 10:04 AM
Return to original view | Post
#166
|
![]() ![]() ![]() ![]()
Senior Member
510 posts Joined: Jun 2012 |
They are now starting on level 13 this morning. The last update on level 12 is on 29 Jan 2013. Approx 2 weeks.
Seem no delay on CNY mood. manage to complete 1 floor in 2 weeks. |
|
|
|
|
|
Feb 18 2014, 03:00 PM
Return to original view | Post
#167
|
![]() ![]() ![]() ![]()
Senior Member
510 posts Joined: Jun 2012 |
QUOTE(electroboy @ Feb 18 2014, 10:57 AM) i found the SOHO build model at endah parade mall sales booth and take a picture of it and compare with the progress. see the red circle in all three photos? it's the missing area not yet build, for some reason. this is what i was talking about earlier for the missing "right side" of the building. if i am correct then when we say it's actually working on 13th floor, it's not really 13th floor, as floor 6 onwards isn't 100% completed Dear Electroboy,As I told you earlier that you are spotted correctly the missing right side. If you passby the site and look that the carpark and shoplot area (level Basement to level 6). You notice that this missing 'right side' is not constructed the same way. Maybe that area is a lift lobby area which need high level of lobby area. So, the contractor can't cast it at 1 go. That could be the reason. As for progress now, they are picking up and constructing level 6 and I am sure they will meet a certain level. |
|
|
Feb 20 2014, 12:53 PM
Return to original view | Post
#168
|
![]() ![]() ![]() ![]()
Senior Member
510 posts Joined: Jun 2012 |
QUOTE(Suzuki688 @ Feb 19 2014, 09:29 PM) Hi Annie, I bought in June 2013, Level 7, already received the progressive interest letter since January... Hi Suzuki688,Yours is SOHO. Ms Annie is The Courts. The Courts finished piling and on foundation progress. They shall bill you soon when the foundation is finish. |
|
|
Feb 21 2014, 02:41 PM
Return to original view | Post
#169
|
![]() ![]() ![]() ![]()
Senior Member
510 posts Joined: Jun 2012 |
|
|
|
Feb 28 2014, 05:25 PM
Return to original view | Post
#170
|
![]() ![]() ![]() ![]()
Senior Member
510 posts Joined: Jun 2012 |
QUOTE(ngaisteve1 @ Feb 27 2014, 06:05 PM) Heard that a new project at jalan cheras already sell at rm700-750psf. Hopefully can fetch a good price also for our project. Central Residence is along jalan sungai besi. Not jalan cheras. How you compare? Quite a distance between them. The nearest you can compare is development near kuchai lama. |
|
|
Feb 28 2014, 06:22 PM
Return to original view | Post
#171
|
![]() ![]() ![]() ![]()
Senior Member
510 posts Joined: Jun 2012 |
|
|
|
Feb 28 2014, 06:37 PM
Return to original view | Post
#172
|
![]() ![]() ![]() ![]()
Senior Member
510 posts Joined: Jun 2012 |
|
|
|
Mar 1 2014, 09:47 AM
Return to original view | Post
#173
|
![]() ![]() ![]() ![]()
Senior Member
510 posts Joined: Jun 2012 |
Ladies & Gentlemen,
Now thet are starting on level 14. Last update was 13 Feb 2014. Their progress are on track and able to finished 1 floor within 2 weeks. So far so good. |
|
|
|
|
|
Mar 6 2014, 11:25 AM
Return to original view | Post
#174
|
![]() ![]() ![]() ![]()
Senior Member
510 posts Joined: Jun 2012 |
QUOTE(electroboy @ Mar 6 2014, 11:14 AM) i happened to call yuktung office this morning to ask something and one of the question is about expectation of VP date for SOHO first phase. and they still giving commitment date by end of this year, no change. I doubt the SOHO can VP by end of this year. Still about 10 level to go and each level take 2 weeks to complete which come out to be 20 weeks or 5 months. Meaning that by August the structure will be completed. Not to forget there are M&E services, surrounding infrastructure and road access for bomba in order to get CF/CCC.last night i passed by CR around 10.40pm, i can still see lights turned on and consturction site is bright but not sure if anyone is working on it or not (because i was driving by only and dont see any worker,but it could mean nothing), my last update when i pass by at night i see the cranes moving and many workers working. I guess the developer masterplan is to get VP by end of the year. Maybe, the maincon schedule got problem and unexpected delay. Don't know whether the maincon have any recovery plan to catch up or else the maincon will kena LAD if their contract is complete by end of the year. Only the maincon and developer will know. |
|
|
Mar 6 2014, 12:18 PM
Return to original view | Post
#175
|
![]() ![]() ![]() ![]()
Senior Member
510 posts Joined: Jun 2012 |
|
|
|
Mar 6 2014, 04:39 PM
Return to original view | Post
#176
|
![]() ![]() ![]() ![]()
Senior Member
510 posts Joined: Jun 2012 |
|
|
|
Mar 6 2014, 04:40 PM
Return to original view | Post
#177
|
![]() ![]() ![]() ![]()
Senior Member
510 posts Joined: Jun 2012 |
|
|
|
Mar 13 2014, 10:04 AM
Return to original view | Post
#178
|
![]() ![]() ![]() ![]()
Senior Member
510 posts Joined: Jun 2012 |
Ladies & Gentlemen,
This morning, I saw that they are starting on level 15. Last update was 1 Mar 2014. Their progress are on track and able to finished 1 floor within 2 weeks. So far so good. |
|
|
Mar 13 2014, 10:56 AM
Return to original view | Post
#179
|
![]() ![]() ![]() ![]()
Senior Member
510 posts Joined: Jun 2012 |
QUOTE(electroboy @ Mar 13 2014, 10:46 AM) Saw that last night too when i passby, looks like they have just started on the next level, and level 6 on the "red circle" i mentiomed last time also looks like it is already been completed. Not bad On the level 6 "red circle", they will catch up and meet at the top level. |
|
|
Mar 17 2014, 02:13 PM
Return to original view | Post
#180
|
![]() ![]() ![]() ![]()
Senior Member
510 posts Joined: Jun 2012 |
QUOTE(heng5410 @ Mar 15 2014, 11:35 PM) Meaning that they have completed (a) Work below ground level of the said building comprising the said parcel including foundation of the said building. for The Courts. They still need to build few level carparks before starting of the residential unit on the 6th floor. |
|
