 Inspirasi Mont Kiara, New Development along Jln Kiara 3

views

tanyauchuan
post May 21 2019, 02:35 PM

Casual
***
Junior Member
379 posts

Joined: May 2019
dunno how to upload photo to u guy, it mention file too big๐Ÿ˜…

inspirasi build quite fast, now level 6 dy for JK4 that block, JK3 that one starting 2nd floor.

Jalan Kiara 4 last 200m is building now by Inpirasi only narrow 2lanes road(1go 1back) cost about rm7million, congrat to inspirasi owner, developer treat u guy so good spend a lot of money๐Ÿ˜…

JK3 i think left 7-9 land for future development, will fully develop in the future, now on going project on JK3 have 1 Kiara(delayed project), Trinity Pentamont, Inspirasi, Sefina.

Coming soon have Bon Kiara for 3blocks resident + shoplot, TWY2 (dont think it will build soon, coz TWY already delay gaogao๐Ÿ˜…)

Sub road behind the TWY have Kiara Kasih government affordable house building now also.
tanyauchuan
post May 21 2019, 02:55 PM

Casual
***
Junior Member
379 posts

Joined: May 2019
https://pictr.com/images/2019/05/21/0DoeUV.md.jpg
tanyauchuan
post May 21 2019, 03:08 PM

Casual
***
Junior Member
379 posts

Joined: May 2019
https://pictr.com/images/2019/05/21/0Dovw5.md.jpg

JK4 entry for Sefina by DBKL, done dy.
entry for inspirasi by developer, in progress, i dont think JK4 will join any other road behind, reason is no more space for it.
tanyauchuan
post Aug 27 2019, 12:59 PM

Casual
***
Junior Member
379 posts

Joined: May 2019
workers take VP move in dy๐Ÿ˜… they clear all the temporary room on Ardena land, is that the Ardena start project soon?? if yes then good, can done around inspirasi date.
tanyauchuan
post Sep 12 2019, 12:44 PM

Casual
***
Junior Member
379 posts

Joined: May 2019

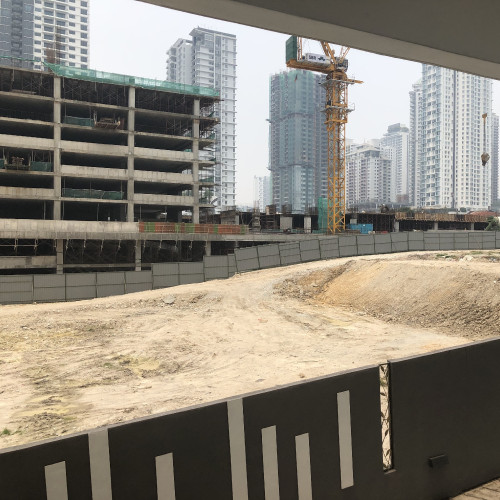

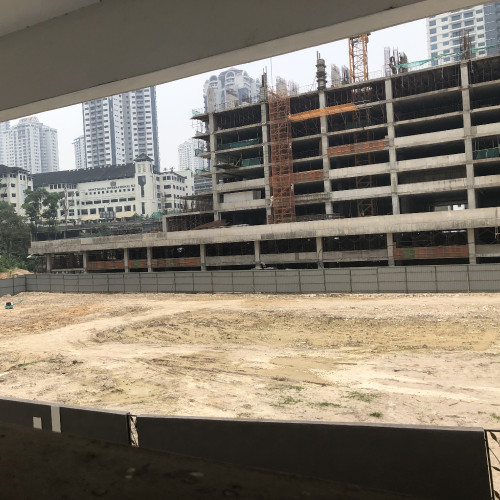

user posted image
user posted image

Basement & Ground Floor is done~ land beside(Ardena) also cleared, maybe the Ardena will start progress soon, if, then these 2 building will done in same year or within 12months, wow, if then, Inspirasi + Ardena + Aston Kiara + Richmood will linked all together dy๐Ÿ˜…
tanyauchuan
post Sep 13 2019, 02:20 PM

Casual
***
Junior Member
379 posts

Joined: May 2019
QUOTE(A.B.D. @ Sep 12 2019, 01:59 PM)
if not mistaken inspirasi has a public bypass road beside the condo, connecting JK3 to JK4. saw it from the scale model at property fair few years ago.
*

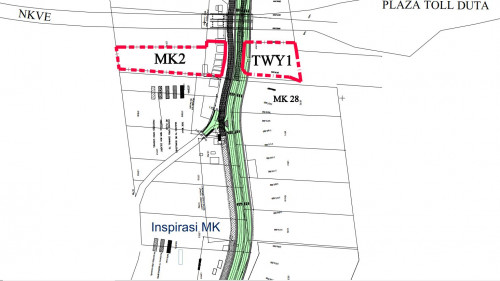

i think nope, coz saw the structure now, the road only enough for Inspirasi use, and JK4 also direct join into Inspirasi(coz funded by MKH about rm7m).

but DBKL Jalan Segambut master plan Phase4(final phase) is JK4, mean in the future, the road of MK join to Jalan Segambut will be JK4 and replace JK3.
tanyauchuan
post Sep 13 2019, 02:24 PM

Casual
***
Junior Member
379 posts

Joined: May 2019
QUOTE(phua8 @ Sep 12 2019, 04:20 PM)
It is difficult, you need to build a bridge across the open channel/big drain.

DBKL's planning is to make Jalan Kiara 4 to be a 6 lanes carriageway. (Became a main road already, continuous from Jalan Segambut)

user posted image
*
haha, about the 6lanes will gg also, coz now the middle of JK4 already done in 2lanes only with both side conrecte high wall, i really dunno how DBKL make it become main road with 6lanes in the future, if only 2lanes for the main road join to Jalan segambut, then future JK4 will more worst than currently JK3๐Ÿ˜…

JK3 become sub road in future can solve the problem of Garden International School problem, reduce the user of JK3.
tanyauchuan
post Sep 14 2019, 01:58 PM

Casual
***
Junior Member
379 posts

Joined: May 2019
QUOTE(phua8 @ Sep 13 2019, 04:52 PM)

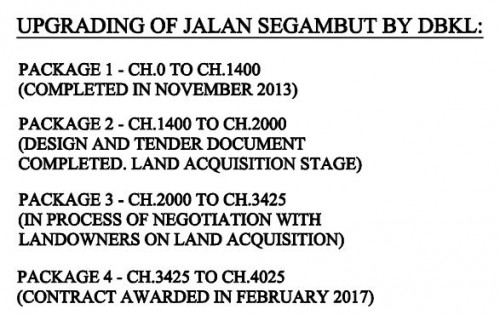

Actually, the Jalan Segambut Upgrade Master Plan Phase 4 already/almost completed (contract awarded since Feb 2017). The portion of JK4 in front of 22 MK & Arcoris up to the Sprint Highway are 6 lanes. (Some cars parked at one of the completed lanes, either left or right, Ha ha..)  The big issue is Phase 3, elevated highway needed to link with Phase 4.
*
JK4 completed??
Jalan Segambut master plan phase 4 not yet start๐Ÿ˜… phase 1 done long time ago, jan2020 start phase 2, phase3 in discussing.
now u saw the phase4 is out of master plan, jist MK plan only, if master plan run wont just do half way, and Inspirasi pay rm7million for the 200m also, if it is master plan then why inspirasi need to pay๐Ÿ˜… because phase 4 not yet start but inspirasi need the road so inspirasi pay by itself.

JK4 done 6lanes?? u see my photo is 2lanes or 6lanes first๐Ÿ˜…๐Ÿ˜…๐Ÿ˜… i confirm my eye saw is 2lanes.

user posted image
tanyauchuan
post Sep 15 2019, 12:42 AM

Casual
***
Junior Member
379 posts

Joined: May 2019
QUOTE(phua8 @ Sep 14 2019, 04:00 PM)
The photo is which part of JK4 ? (Sorry can't find it)

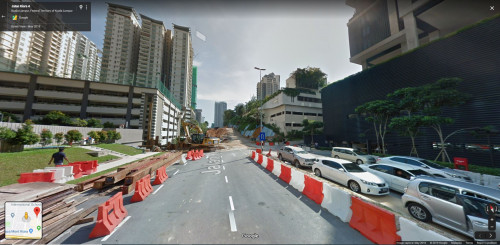

Go to Google Map now, you can find part of the JK4 is 6 lanes, this falls under the Phase 4's region, further up uncompleted's is Phase 3 and road to Inspirasi.

But I don't know there got another MK plan other than the Master Plan. If the 2 plans are overlapping (at Phase 4's portion), it is a waste of money.

user posted image
*
the photo show behind the Sefina is just 2lanes.

i go DBKL presentation dy, phase 4 is the entire JK4 until under the NKVE bridge.

from Sefina to Inspirasi about 200m road is funded by MKH it own money because they want the selling point of inspirasi link to JK4, the cost them rm7million newspaper reported dy.

Jalan Segambut master plan phase 4 mean JK4 not yet start even discussion also not yet, phase 2 start Jan2020 about rm40m+, phase 3 in dicussing about rm100m+, phase 4 not in disccussing currently.

Google map street view maybe only show until before Sefina, need some update~ my photo show currently JK4 end after Sefina, MKH in progress the 200m end up will till Inspirasi~

yes, not u feel weird, i also feel weird why JK4 under Jalan Segambut master plan phase 4, but the road still build 2lanes & 200m funded by MKH๐Ÿ˜…๐Ÿ˜…๐Ÿ˜…
tanyauchuan
post Sep 15 2019, 04:18 PM

Casual
***
Junior Member
379 posts

Joined: May 2019
QUOTE(phua8 @ Sep 15 2019, 02:35 PM)
I attended the Taklimat/Dialog with DBKL too last month.

Not entire JK4 is under Phase 4.

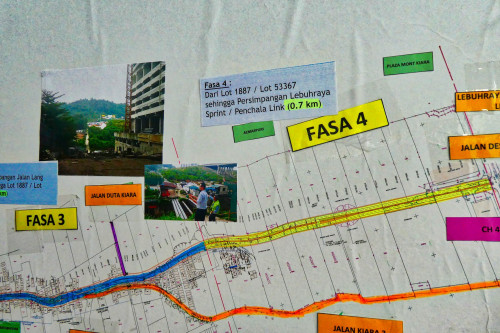

Phase 4 (Yellow) only expansion of the existing JK4 (from Sefina to the South > Jalan Desa Kiara/Sprint Highway)

While Phase 3 (Blue) from Sefina to the North > beneath NKVE bridge to Jalan Lang Emas which is a new road under discussing (a portion of it in JK4).
The 2 lanes road built by MKH could be a temporary solution, it will be expanded when Phase 3 materialized.
user posted image
user posted image

user posted image
*
ya not entire, my meaning is currently the JK4 2lanes with both side high concrete wall, wont be temporary road, temporary road is like kampung๐Ÿ˜… u go JK4 and see the 2lanes then u will know is permanent or temporary๐Ÿ˜… the 2lanes not build by MKH, it already done by DBkL until sefina, MKH 200m is Sefina to Inspirasi only, or u can use measurement tape to measure the 200m๐Ÿ˜…

i suggest u go JK4 and see the road posible become 6lanes in future or not first~๐Ÿ˜…

user posted image

Government 2lanes is from Acoris till Sefina
MKH 2lanes is from Sefina to Inspirasi 200m only as media report
tanyauchuan
post Sep 15 2019, 04:24 PM

Casual
***
Junior Member
379 posts

Joined: May 2019
i saw the DBKL using old plan also, many building no update in the paper plan, u comapre the phase4 n google map, lanes already different now, mean currently JK4 is not under phase4, so when DBKL start discussing phase4 will only relised the road is fixed dy๐Ÿ˜… if want rebuild the road to match phase4 design i guess will waste more money to demolish and re structure, so i guess at the end DBKL will say since the JK4 is done like this dy, so phase 4 will adjust to match the currently condition, wont be DBKL waste so much money to re build it๐Ÿ˜…

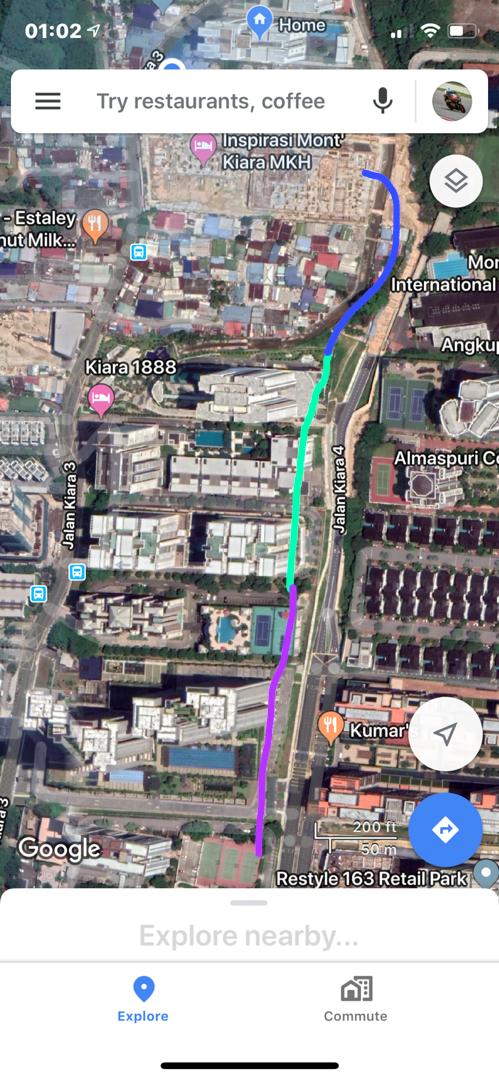

tanyauchuan
post Sep 18 2019, 01:56 PM

Casual
***
Junior Member
379 posts

Joined: May 2019
user posted image

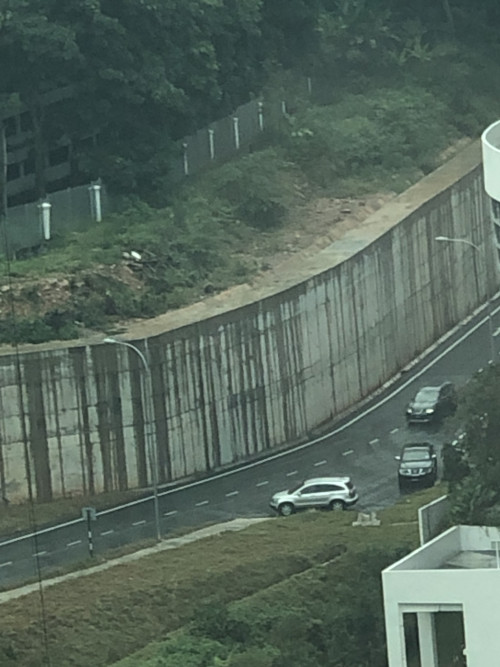

Jalan Kiara 4 2lanes with both side extreme high concrete wall~ ๐Ÿ˜… Jalan semgambut phase 4 design varied from the current road, thats why i confirm Jalan Kiara 4 now is not under Jalan Segambut master plan.

if JK4 become main road in the future with this 2lanes, confirm more worst than JK3๐Ÿ˜…
tanyauchuan
post Sep 18 2019, 04:27 PM

Casual
***
Junior Member
379 posts

Joined: May 2019
QUOTE(A.B.D. @ Sep 18 2019, 02:12 PM)
wah so fast ardena land cleared already i thought using as car park for the kampung?
*
it use by Inspirasi as storage before, but cleared, now left the car park and the site fencing also replace back dy~ i saw surveyor point and leveling the land dy, i giess soon will start progress the building, now see the signboard when put on only can confirm~
tanyauchuan
post Sep 20 2019, 03:37 PM

Casual
***
Junior Member
379 posts

Joined: May 2019
QUOTE(phua8 @ Sep 19 2019, 04:14 PM)

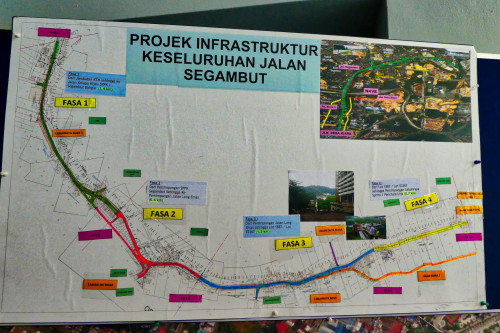

I found this press release for the DBKL presentation.

Phase 4 already completed. (3rd paragraph) ; the Yellow road in the plan.
But the question is 2 lanes or 6 lanes ?  :confused:

(There is typo error : The Phase 3 should be costs RM100mil in lieu of RM10mil, for the 1.3km)

https://www.thestar.com.my/metro/metro-news...grading-of-road
*
lol~ then phase4 not stick with the plan๐Ÿ˜… coz plan is 6lanes, now it done only 2lanes with both side very high concrete wall, gg dot com, mean JK4 is like that only๐Ÿ˜…

if JK4 replace JK3 in future, then JK4 will gg dot com, then JK3 will happy and release the jam pressure~

๐Ÿ˜…๐Ÿ˜…๐Ÿ˜… then JK4 is a joke with the 2lanes๐Ÿ˜…๐Ÿ˜…๐Ÿ˜… even 6lanes at begining, 6lanes at the end, middle 2lanes also same traffic flow

if phase4 done dy, then i dunno why Inspirasi need to pay rm7million to build the 200m of JK4๐Ÿ˜…๐Ÿ˜…๐Ÿ˜…
tanyauchuan
post Sep 21 2019, 02:24 PM

Casual
***
Junior Member
379 posts

Joined: May 2019
QUOTE(phua8 @ Sep 20 2019, 05:41 PM)
6 lanes still possible if part of the Phase 3 is elevated highway, especially the portion in JK4 and merged at the 6 lanes JK4 at MK 22 / Arcoris. (refer to the drawing cut-sheet in my previous post #890, showing 6 lanes road passed TWY1, MK28)

Remember DBKL budget RM100mil for Phase 3 for 1.3km while Phase 2's  0.6km only needs RM40mil.

The RM7mil road can served as private road for Insperasi. (Guessing only)  rolleyes.gif
*
nothing is impossible, new 2lanes make it become 6lanes, need demolish the both side new concrete wall๐Ÿ˜…๐Ÿ˜…๐Ÿ˜… have money what also posible, 2lanes with both side high concrete wall is real dy, this is what we can see the truth

rm7mil i dont think is private road, coz there is no space dy๐Ÿ˜… confirm the road is JK4 dy, not sub private road~ even after 200m extend again also on the river/longgang dy, both side also have building.
tanyauchuan
post Sep 24 2019, 12:18 AM

Casual
***
Junior Member
379 posts

Joined: May 2019
QUOTE(nutsluv00 @ Sep 23 2019, 07:03 PM)
yesterday i go to the showroom n site visit. i considered to buy this project. worth it or not i buy this inpirasi. need the opinion from the buyers.

Thank you
*
2 entrances at JK3 & JK4, not bad~
tanyauchuan
post Sep 24 2019, 03:54 PM

Casual
***
Junior Member
379 posts

Joined: May 2019
QUOTE(dan_lucifer @ Sep 24 2019, 12:05 PM)
only 3 plot of lands left in mont kiara.

inspirasi, ardena and pentamont coming. i can see the road from jalan kiara 4 going in.
*
yes JK4 join into Inspirasi~

JK3 still have many project, TWY2, Bon Kiara.

JK3 will have 1sub road(no name yet) to RumahWiiP project Kasih Kiara, opposite Kasih Kiara seem like flatten now maybe have an other project.

very possible JK5 can extend till Kasih Kiara in the future, coz the rest land of JK5 maybe owned by private sector dy~
tanyauchuan
post Oct 21 2019, 03:22 AM

Casual
***
Junior Member
379 posts

Joined: May 2019
QUOTE(Sirena @ Oct 18 2019, 08:19 AM)
<a href='https://pictr.com/images/2019/10/18/5Vhz6c.md.jpg' target='_blank'>https://pictr.com/images/2019/10/18/5Vhz6c.md.jpg </a>
Did anyone buy any units level 23 and above No 7? Whats your thoughts of buying unit opposite the lift lobby? Thanks ๐Ÿค”
*
if the lift have sound, then will feel like living in the mircrowave๐Ÿ˜…

if the lift no sound then good, no need walk so much n can always meet all the neighbour
tanyauchuan
post Oct 22 2019, 01:09 PM

Casual
***
Junior Member
379 posts

Joined: May 2019
QUOTE(Sirena @ Oct 21 2019, 10:00 PM)
Yes lift will be separated with a thick door then only reisendt enter cooridor. The foyer is also 5x7 sq feet so not directly in front of lif opening๐Ÿ˜€
*
fire resistant door, i hate this design๐Ÿ˜… useless door and block the walkway, but developer can save cost for installing each unit fire resistant door๐Ÿ˜…
tanyauchuan
post Oct 30 2019, 03:19 PM

Casual
***
Junior Member
379 posts

Joined: May 2019
why inspirasi stop work dy๐Ÿ˜… waiting ardena catch up๐Ÿ˜…๐Ÿ˜…๐Ÿ˜…๐Ÿ˜…๐Ÿ˜…๐Ÿ˜…
