QUOTE(propertybbb @ Oct 31 2017, 01:43 PM)
J n H launched together....but still how to derive the 10mths?
Normally discussion is kept in chat group.
Perhaps we need also your expertise in helping the x value.

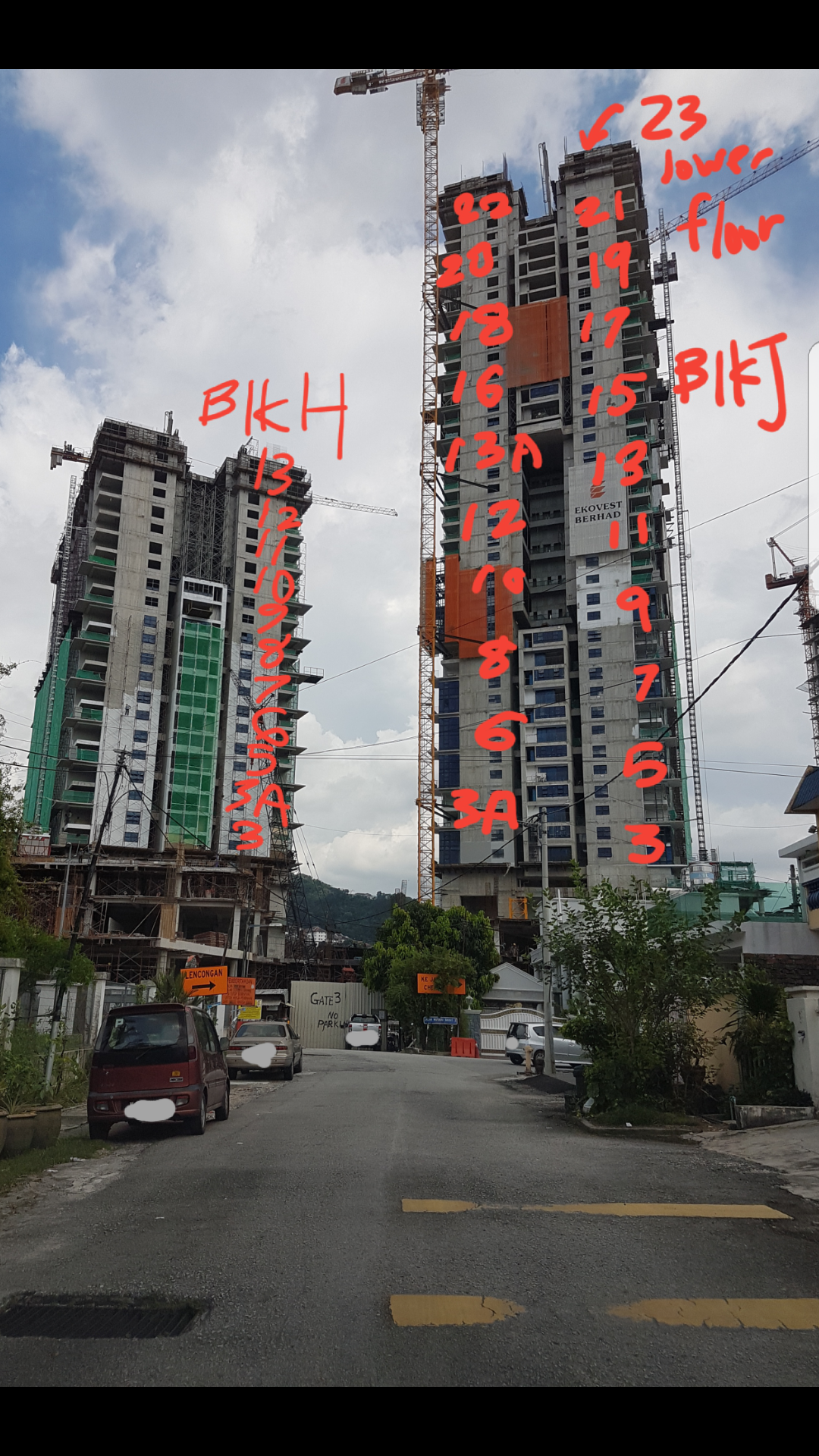

BlkH progress
05-Feb L3 in progress
26-Feb Lower floor of L3 in progress
26-Mar Lower floor of L3A in progress
07-May Lower floor of L5 in progress
18-Jun Lower floor of L6 in progress
20-Aug Lower floor of L9 in progress
29-Oct Lower floor of L13 in progress
BlkH has speeded up a bit from Jun, delivering about 3 duplex-floors(df) in 2 months(pace 1.5df/mth). From 20-Aug, it is observed an increments to 4 more duplex-floors in 29-Oct ie 70 days(pace 1.75df/mth).
Now the following guesstimation depends on which pace to choose.
Assuming to use the fastest observed pace (if they can at least maintain this 1.75df/mth pace), it takes another 9.4mths to start the facility deck / sky bridge work of this building.
This is only the construction progress that is guesstimated. After construction, paper work and final approval will take place until key collection.
In short, BlkH
Now to L30 upper floor = ~9.4mths (1.75df/mth)
Pace of L31(facility) = ~1 mth (inclusive all pipings, window frames/glasses, kitchen cabinets, a/conds etc are fully installed to all units)
Paper work till VP = x mth (anyone knows the shortest window?)
Putting any potential EoT aside, how would you calculate the LAD for first batch buyers (signed in Dec-2013 for 48 mths construction period)? Thx
